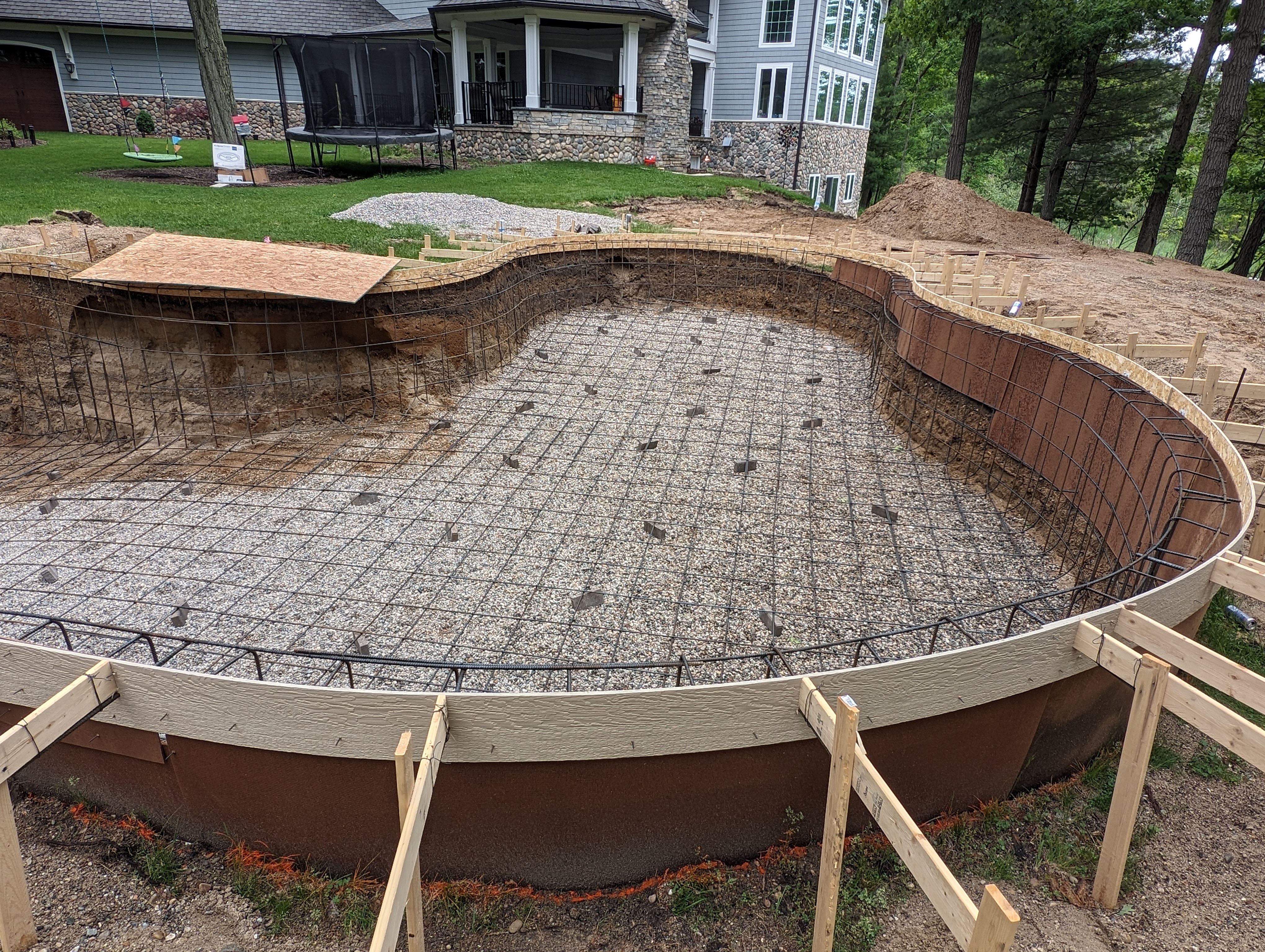

There were a few days of inactivity in progress in the pool in which all the big snapping and painted turtles from the lake came up on dry land to dig nests and lay eggs. I had to rescue a few of the snappers from the pool after they went in between the gaps of the concrete pool and couldn't climb out. The installers came back on Memorial day and put in a half day of work to finish installing all the metal rebar for the pool shell. 5 guys worked in tandem to install and tie all the straight pieces of rebar together to conform to the curves of the pool and prep it for plumbing and finally gunite shooting. I'm surprised how quickly it all went in but it's in.
Wednesday, May 29, 2024
One Day Metal Install
Wednesday, May 22, 2024
Digging a Big Hole Complete
The excavation machines are gone and my driveway is once again clear so I'm calling the digging portion of the pool done. The forms all look installed with the exception of a gap here or there, which should be inconsequential. I think the next steps should be plumbing stubs into the pool, metal framework, inspection, then gunite application.
Here's a shot of the entire pool from the lawn side. They had some sheets of the fiberboard left, but you can see how much height needed to be adjusted for due to the drop in grade towards the water. There's an optical illusion where it looks like it's increasing in height on the lake side, but it's all level.Here's the pile of sand that was left ungraded after the excavators were driven away. It's either there to fix the grade in the end, or provide extra fill for backfilling after the pool is shot. Even if it's not all used in the immediate area, there are plenty of places along the edge of the driveway that I've been meaning to bolster with fill.
Tuesday, May 21, 2024
Digging a Big Hole part 3
Into the second week of work on the pool and prepping for the gunite. With the stakes installed over the weekend, today's work was centered around installing the upper edge forms and the wood used to hold them in place. Since the grade on the lake side of the pool is below what the final grade will be, forms are needed to make up the height so the gunite has something to be sprayed against. The form also sets the final upper edge shape and height of the pool. The top edge of a pool shell is usually much thicker and is formally called the bond beam. It's tied into the rebar of the pool wall and is usually as wide, or slightly wider than the pool coping stone. Currently the forms are at the setback of the excavation so I don't know how the bond beam will be constructed until the metal starts to go in.
Here you can also see the height differential between initial grade and what is expected to be final grade. Just like on the lawn side of the pool, the curved forms here sit a little above final grade, but not by much. The rest of the space will be filled with the fiberboard sheets, cut to height.
Monday, May 20, 2024
Digging a Big Hole Part 2
I have a double header update since things are moving pretty quickly with the prep for gunite. They finished digging out the perimeter and rough depth of the pool and moved in some gravel for the base. Some forms are needed at the top lip of the pool on which the pool coping stone will sit. I'm not sure how all this will tie into the earthen berms on the back side of the pool since that is supposed to be the top level, but I'm guessing all will be revealed when they start to install the metal.
Here's the view of the pool from the shallow end, and what will eventually be the main part of the pool deck. The distance from the rod to one of the rods on the far end of the pool should be around 40 feet, which will be a pretty good distance for straight line swimming exercise. If you look closely, each metal rebar rod has a small piece of orange string tied to it, indicating final grade height. The string on the yard side of the pool is just a coping stone height off the grass, which gives a good indication on how much of an elevation drop there is on the lake side of the pool.
Thursday, May 16, 2024
Digging a Big Hole Part 1
Things are moving quickly but it's the hurry up and wait phase of the build. Basically the way to make a gunite pool is to dig a hole about the wall thickness greater than what you want for the pool, 12 inches in this case, install metal rebar and water circulation ports, wait for metal inspection, then shoot the gunite at the metal and smooth the inside. The wait part is the roughly 28 days it takes to cure before you can apply the finishing materials. So here we are, at the start of the hole digging phase, but it really gives you a good idea what the pool will look like when finished.
Here's another shot of the soil stratification. I guess we're lucky to be on sand since we don't have to worry about water drainage issues. You can see the thing, 2" layer of topsoil laid down when the yard was leveled. While it might be good enough for grass to grow, it doesn't create a deep root zone to make the grass more drought tolerant. Since most of the undisturbed yard is like this, I'll have to keep applying top dressing amendments to try to grow that fertile zone deeper.
Wednesday, May 15, 2024
Silt Fence and HOA approval
Thursday, May 2, 2024
Pool Engineering Drawings
Things have really started to move into high gear in these early stages of construction so I'll try to keep up with the updates. I've seen pool building estimates between 2-6 months and Eli has said that he's looking at finishing the pool near the end of swimming season so maybe it will be possible to take a dip before it gets too cold and we'll have to close it for the winter.
So far, we've gotten final designs, local permitting, interim HOA approval. When building the house, we had the foresight to install a breaker panel and gas line in the storage space under the back deck, so all that can be pulled from that location. Initially, we were hoping to house all the pool filtration and heating equipment under the gazebo area, but looking at the build pictures, it looks like there's only 5 feet to the footer inside and I would need to excavate around 1.5 feet of backfill to reach that depth. Additionally, the pool filter will need around 6 feet of operating height to for filter servicing. The final nail in the coffin was the heater clearances. Since it's a gas operated heater, there are installation codes dictating air make up and spacing requirements, which I don't think we'll meet in that space. The pool equipment is designed to work in an outdoor environment and most people just stash it on the ugly side of their house, but we don't have an ugly side so placing it will be an issue we'll have to deal with.

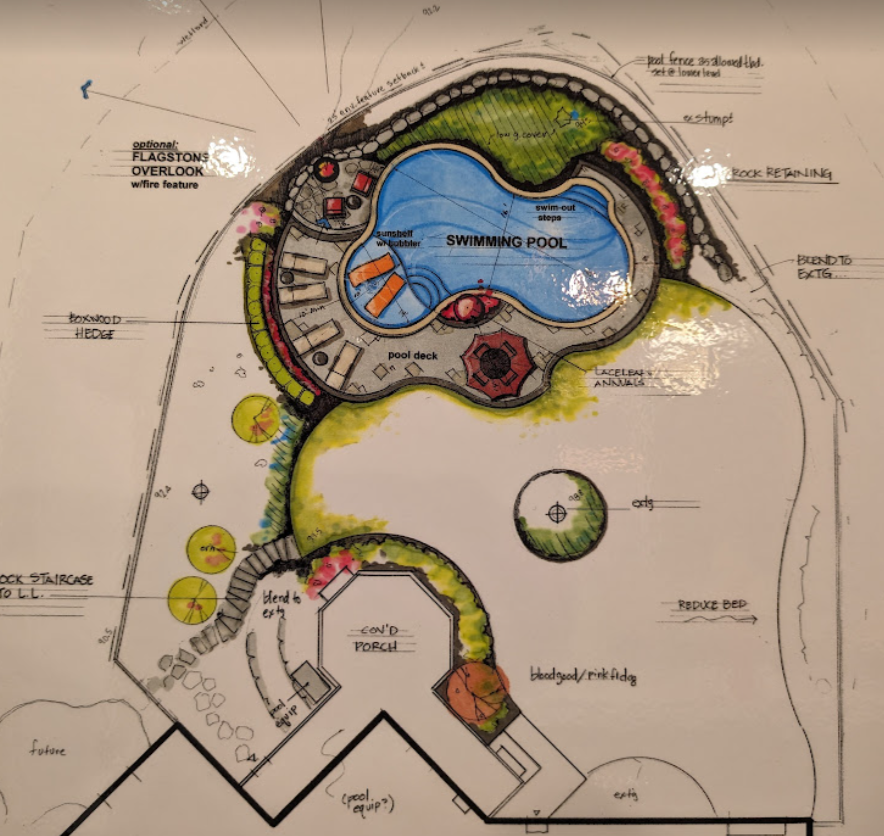

Eli obtained the engineering drawings and recently shared them with me. It contains yard elevations based off the initial plot survey and adds the pool design, showing elevation measurements for the final surfaces.
Wednesday, May 1, 2024
Time Skip: Pool Time
Oh boy, what a year it's been. What? Three years have past? Well I guess most of you know what has been going on globally in the past three years. Personally, we've been getting by, making a new kid and raising the two we already have, and trying to tackle small projects while saving up for the big one. The biggest one. It's time to get that swimming pool built.
We've always had an eye on installing an in-ground pool since the inception of the house. The initial landscaping plans created way back in 2015 (almost 10 years ago?!?) had a rectangular pool with a squared off pool decking area surrounding it.
Sharp edges gone! Pool size increased to roughly 40 ft. along the most unobstructed swim path by 16 ft. in the narrowest part. A few items of note:
- No spa. A spa and associated additional equipment would have probably added around $30k-$40K to the overall price and be unusable in the winter time, since the plumbing is all combined. We're reserving the right to have an above ground hot tub somewhere else in the future.
- The pool depth will be around 3.5 ft. in the shallow to around 6.5 ft in the deep. We're not going with a true diving depth because of increased insurance cost and increased depth transition change.
- The submerged sundeck is still in the plans, with the addition of a little bubbler. It will be a nice place to sit semi-submerged or have the little one play in. Also, having just part of the width populated with steps makes the other part a nice sitting place.
- The swim out steps on the right, in the deep end, will also make a nice place to sit partially submerged.
- The placement of the main pool deck area has the most sun exposure during the majority of the day.
- The green space at the top of the pool will be planted with low ground covering right up to the retaining wall, to partially simulate an infinity edge.
- Besides the lounging area, there will be a space for a table and a slightly lower sitting area for a fire pit. Will probably just get a portable pit like a solo stove rather than having another permanent fire enjoying device (fireplace in the gazebo).
